Water Supply Line Replacement

Share Water Supply Line Replacement on Facebook Share Water Supply Line Replacement on Twitter Share Water Supply Line Replacement on Linkedin Email Water Supply Line Replacement link

The City is installing a new water supply pipeline to improve the overall resiliency of the City’s water system. The new water supply line will replace a section of the aging Seattle Public Utilities transmission line that currently serves Mercer Island by delivering water to the City’s reservoirs. The new water supply line will be fully owned and operated by the City. See the Project Map here.

In addition to the new water supply line, this project includes improvements to other City infrastructure in the same corridor including replacement of an asbestos-cement (AC) watermain, roadway paving and sidewalk enhancements. Combining these improvements into one project improves project efficiency, scheduling, reduces costs and overall construction impacts.

Follow this page for details of the design and construction of the new water supply pipeline, as well as neighborhood and traffic impacts through the project.

The City is installing a new water supply pipeline to improve the overall resiliency of the City’s water system. The new water supply line will replace a section of the aging Seattle Public Utilities transmission line that currently serves Mercer Island by delivering water to the City’s reservoirs. The new water supply line will be fully owned and operated by the City. See the Project Map here.

In addition to the new water supply line, this project includes improvements to other City infrastructure in the same corridor including replacement of an asbestos-cement (AC) watermain, roadway paving and sidewalk enhancements. Combining these improvements into one project improves project efficiency, scheduling, reduces costs and overall construction impacts.

Follow this page for details of the design and construction of the new water supply pipeline, as well as neighborhood and traffic impacts through the project.

  • Design & Planning Update

    Share Design & Planning Update on Facebook Share Design & Planning Update on Twitter Share Design & Planning Update on Linkedin Email Design & Planning Update link

    The City’s consultant, RH2 Engineering, completed their 60% design plans in December for the new 24-inch water supply pipeline along SE 36th Street, Gallagher Hill Road, and SE 40th Street, as well as roadway improvements following the water main work. RH2 recently completed 90% design plans for a new 10-inch ductile iron water main along Gallagher Hill Road that will replace an existing asbestos cement (AC) water main. This old water main needs to be replaced prior to installation of the new 24-inch Supply Pipeline. Staff are currently reviewing these designs and will present a project update to the Council in April. Construction of the 10-inch water main could start as early as May 2026.

  • Water Supply Line Project Update to City Council

    Share Water Supply Line Project Update to City Council on Facebook Share Water Supply Line Project Update to City Council on Twitter Share Water Supply Line Project Update to City Council on Linkedin Email Water Supply Line Project Update to City Council link

    At the October 21, 2025 City Council meeting, the Council received an update on the Water Supply Pipeline project. Design work by RH2 and construction coordination by Scarsella Brothers Inc has continued and has reached the 60% stage milestone.

    The new pipe alignments, general footprint of the project, and roadway improvements are identified. Initial cost estimates have also been completed. While there are some remaining scope elements to be defined, the project is moving towards construction in Q1 2026.

    This project has two primary phases: water and roadway. The underground and water work will occur first, starting in March 2026 and this is anticipated to last 10 to 12 months. Roadway improvements will follow, beginning in early spring 2027 and are estimated to take approximately 8 months to construct. Substantial completion of the project is expected by the end of 2027.

    Read the full report here.

  • Project & Design Update

    Share Project & Design Update on Facebook Share Project & Design Update on Twitter Share Project & Design Update on Linkedin Email Project & Design Update link

    The City’s design consultant is nearing completion of the 60% design plans, which include a new 24-inch water supply pipeline along SE 36th Street, Gallagher Hill Road, and SE 40th Street, a new 10-inch ductile iron pipe along Gallagher Hill that will replace an existing asbestos cement (AC) water main, and roadway improvements following the water main work. City staff, in coordination with RH2 (the design consultant) and Scarsella (the contractor), will be reviewing the 60% plans, specifications, and cost estimates in the coming weeks, as well as discussing construction sequencing and duration.

  • State to Help Fund Water Line Replacement

    Share State to Help Fund Water Line Replacement on Facebook Share State to Help Fund Water Line Replacement on Twitter Share State to Help Fund Water Line Replacement on Linkedin Email State to Help Fund Water Line Replacement link

    The City of Mercer Island has secured $1.2 million in funding for a new water supply line in the State of Washington’s Capital Budget that was recently adopted during the 2025 legislative session. The pipeline’s replacement became necessary after a leak in a segment was discovered in April of 2024, which required emergency repairs that reduced its overall capacity.

    Given the importance of this water supply line, the City explored options for a stronger, earthquake resistant replacement that will improve overall resiliency of the water system. The City Council authorized staff to include design and construction of a new water supply line in the 2025-2030 Capital Improvement Plan (AB 6530).

    At its meeting on July 15, the Council formally expressed its appreciation for the efforts of the 41st Legislative District’s elected officials – Senator Lisa Wellman and Representatives Janice Zahn and My-Linh Thai – who applied for this funding on behalf of the City and voted for its inclusion in the Capital Budget.

  • July 18, 2025 - 30% Design Plans Submitted

    Share July 18, 2025 - 30% Design Plans Submitted on Facebook Share July 18, 2025 - 30% Design Plans Submitted on Twitter Share July 18, 2025 - 30% Design Plans Submitted on Linkedin Email July 18, 2025 - 30% Design Plans Submitted link

    RH2, the City’s design consultant, has submitted their 30% design plans, which define the proposed alignment for the new 24-inch water supply pipeline along SE 36th Street, Gallagher Hill Road, and SE 40th Street, as well as a new 10-inch ductile iron pipe along Gallagher Hill that will replace an existing asbestos cement (AC) water main. RH2, in coordination with Scarsella (the contractor) and City staff, held a meeting to review the 30% plans and initiate discussions on construction sequencing and potential traffic control strategies during construction. To support the evaluation of traffic detour options, RH2 will conduct traffic counts and perform related analysis in the coming weeks.

  • June 17, 2025 - Design Phase Nears 30% Completion

    Share June 17, 2025 - Design Phase Nears 30% Completion on Facebook Share June 17, 2025 - Design Phase Nears 30% Completion on Twitter Share June 17, 2025 - Design Phase Nears 30% Completion on Linkedin Email June 17, 2025 - Design Phase Nears 30% Completion link
    supporting image

    The City, in collaboration with RH2 and Scarsella, is currently advancing the 30% design phase, with completion anticipated by mid-July. Comprehensive site surveying and mapping have been completed, including field visits to verify existing conditions. A preliminary alignment for the new water main has been established. In addition, initial coordination with WSDOT is underway to begin the permitting process, as the project crosses WSDOT right-of-way at the intersections of SE 36th Street and East Mercer Way.

  • May 27, 2025 - City Selects Contractor for Supply Line Project

    Share May 27, 2025 - City Selects Contractor for Supply Line Project on Facebook Share May 27, 2025 - City Selects Contractor for Supply Line Project on Twitter Share May 27, 2025 - City Selects Contractor for Supply Line Project on Linkedin Email May 27, 2025 - City Selects Contractor for Supply Line Project link

    At the May 20, 2025 City Council meeting, the City approved the Scarsella Brothers, Inc.as the Heavy Civil General Contractor/Construction Manager (GC/CM) for the new water supply pipeline for the City of Mercer Island. With GC/CM alternative delivery method, the contractor is involved in the design phase of the project to aide with project decisions which supports a more efficient and cost-effective project outcome.

    Read more here.

  • April 1, 2025 - City Selects Design Consultant

    Share April 1, 2025 - City Selects Design Consultant on Facebook Share April 1, 2025 - City Selects Design Consultant on Twitter Share April 1, 2025 - City Selects Design Consultant on Linkedin Email April 1, 2025 - City Selects Design Consultant link

    After a competitive interview process, the City selected RH2 as the design consultant for the project. RH2 will lead the design in coordination with the City and the GC/CM, who will be selected in the next couple months.

  • Alternative Delivery for Design & Construction

    Share Alternative Delivery for Design & Construction on Facebook Share Alternative Delivery for Design & Construction on Twitter Share Alternative Delivery for Design & Construction on Linkedin Email Alternative Delivery for Design & Construction link

    The City has selected to use an alternative delivery method to design and construct this project. The City presented the project to the state’s Project Review Committee in December 2024, as required for utilization of alternative delivery methods in public works construction. The project received unanimous approval to use the Heavy Civil General Contractor/Construction Manager (GC/CM) project delivery. This alternative delivery was selected for this project to help reduce project costs, schedule and risk.

  • Project Components

    Share Project Components on Facebook Share Project Components on Twitter Share Project Components on Linkedin Email Project Components link

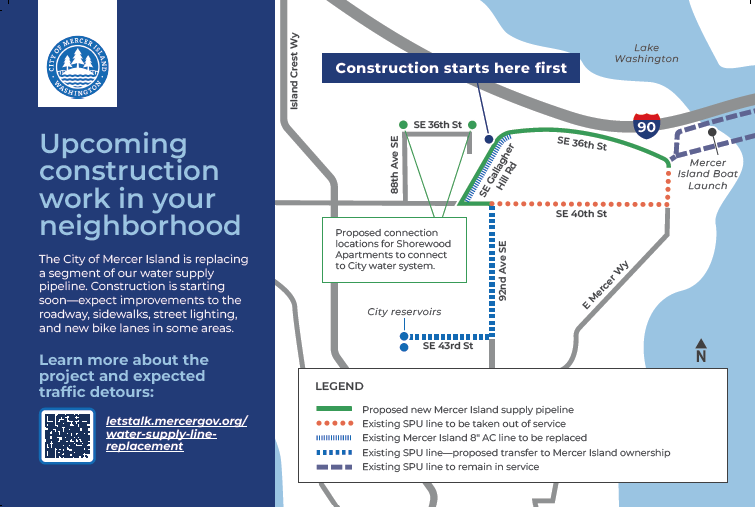

    supporting image

    The water supply line replacement project consists of several components:

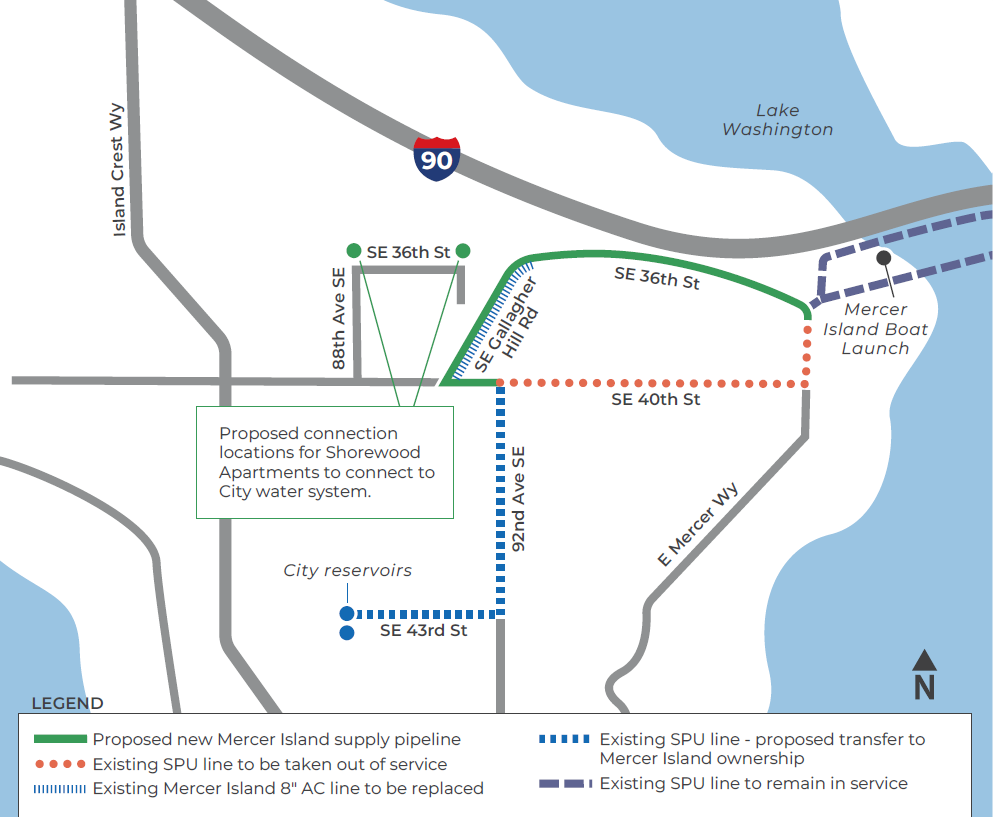

    New Water Supply Line: The new 24-inch water supply line will run from the Boat Ramp area, heading north on East Mercer Way, west on SE 36th Street, and southwest along SE Gallagher Hill Road to SE 40th Street, continuing east on SE 40th to 92nd Ave SE. Additionally, the project will involve relocating the SPU master meter and upsizing an existing 12-inch water line section of supply line at the intersection of 89th Avenue SE and SE 43rd Street to 24-inch pipe.

    AC Watermain Replacement: Approximately 1,500 feet of existing 8-inch and 10-inch AC pipeline will be replaced, as well as the replacement of a large Pressure Reducing Valve (PRV) at the bottom of SE Gallagher Hill Road. Additionally, the project will extend the pipeline to the top of SE Gallagher Hill Road and establish a new connection at the intersection of SE 40th Street and SE Gallagher Hill Road.

    Roadway Improvements: Roadway improvements will be constructed, following the water supply line installation, testing, and startup. The scope of these improvements include:

    • SE 36th Street (Gallagher Hill Road to East Mercer Way) – Restore sidewalks removed for pipeline construction, upgrade all sidewalk ramps to meet current ADA standards, mill and repave the roadway with a hot mix asphalt (HMA) overlay, raise utilities to grade, and install new pavement markings.

    • Gallagher Hill Road (SE 40th Street to SE 36th Street) – Construct new curb and sidewalk along the east side (downhill lane), provide a paved shoulder suitable for bicycle use on the west side (uphill lane), install a HMA overlay, raise utilities to grade, and install new pavement markings.

    • SE 40th Street (Gallagher Hill Road to 93rd Avenue) – Construct new curbs and sidewalks on both sides, install bike lanes on both sides, install a HMA overlay, raise utilities to grade, and install new pavement markings. Together, these improvements will repave approximately 0.9 miles of arterial roadways.

    Shorewood Apartment Connection: Two connections and master meters will be installed to provide water service to Shorewood Apartments.
