Comprehensive Plan GMA Compliance

Share Comprehensive Plan GMA Compliance on Facebook Share Comprehensive Plan GMA Compliance on Twitter Share Comprehensive Plan GMA Compliance on Linkedin Email Comprehensive Plan GMA Compliance link


In 2024, the City of Mercer Island adopted a Comprehensive Plan Periodic Update, which was appealed to the Growth Management Hearings Board in 2025. The appeal resulted in a Final Decision and Order, which requires the City to update the Comprehensive Plan to comply with four requirements by July 31, 2026.



In 2024, the City of Mercer Island adopted a Comprehensive Plan Periodic Update, which was appealed to the Growth Management Hearings Board in 2025. The appeal resulted in a Final Decision and Order, which requires the City to update the Comprehensive Plan to comply with four requirements by July 31, 2026.


  • City Council Commences Work to Develop Compliance Strategy

    Share City Council Commences Work to Develop Compliance Strategy on Facebook Share City Council Commences Work to Develop Compliance Strategy on Twitter Share City Council Commences Work to Develop Compliance Strategy on Linkedin Email City Council Commences Work to Develop Compliance Strategy link

    At its annual planning session today, the Mercer Island City Council initiated a strategic effort to align the City’s Comprehensive Plan with state affordable housing requirements. Following a recent Growth Management Hearings Board (GMHB) order requiring the City to revise its plan by July 31, 2026, the Council has committed to a path forward over the coming months to ensure the City meets its obligations.

    Under the Washington State Growth Management Act (GMA), cities and counties are required to adopt a comprehensive plan, which is a statement of goals and policies that detail how a county or city will manage and accommodate future growth. The goals and policies of the comprehensive plan are implemented through capital investments, development regulations, and programs. The GMA requires cities and counties to periodically review and update their comprehensive plans on a ten-year cycle. Mercer Island most recently completed a periodic review and update of its Comprehensive Plan in 2024 (see AB 6573).

    The 2024 Comprehensive Plan was appealed to the GMHB on the grounds that the Comprehensive Plan did not adequately plan for and accommodate future affordable housing needs (GMHB case number 25-3-0003). On Aug. 1, 2025, the GMHB issued a final decision and order (GMHB Order), which found that the City must revise its Comprehensive Plan to comply with the GMA and remanded the Comprehensive Plan to the City for revision. Specifically, the City must amend its Comprehensive Plan to address the following:

    • Land Capacity: Analyze residential land capacity at each housing affordability level and close any identified gaps.
    • Adequate Provisions: Adopt incentives, mandatory provisions, and planned actions (“aka adequate provisions”) that will increase the supply of affordable housing.
    • Station Area Subarea Plan: Adopt a subarea plan for the area around the transit station.
    • Anti-Displacement Measures: Adopt anti-displacement measures to address the potential displacement that can occur with changes in zoning.

    Although the Comprehensive Plan adopted in 2024 remains in effect during the remand, the City must update the plan and comply by July 31, 2026, which is one year from the date that the GHMB issued its decision, as established by the GMHB Order (RCW 36.70A.300(3)(b)). Failure to comply with the GMHB Order can result in sanctions against the City (RCW 36.70A.340).

    Staff began developing compliance strategies and presented proposed options for City Council consideration and direction on Jan. 16, 2026. The Council provided direction on the preferred strategies and requested additional analysis, implementation options and a refined work plan and schedule for Council consideration in February and March of 2026. Based on the City Council direction, Mercer Island will evaluate how compliance with another state law, House Bill 1491, may efficiently address the GMHB Order. Compliance work will continue thereafter with regular City Council briefings and direction, until compliance is achieved.


  • What the Transit-Oriented Development Bill Means for Mercer Island

    Share What the Transit-Oriented Development Bill Means for Mercer Island on Facebook Share What the Transit-Oriented Development Bill Means for Mercer Island on Twitter Share What the Transit-Oriented Development Bill Means for Mercer Island on Linkedin Email What the Transit-Oriented Development Bill Means for Mercer Island link
    supporting image

    In 2025, the Washington State Legislature adopted House Bill (HB) 1491 (known as the “TOD Bill”), which established requirements for local jurisdictions to plan for transit-oriented development (TOD) in areas within a half-mile walk of any light rail station, also referred to as a “station area.” (see map below). HB 1491 was designed to encourage mid-rise development within the station area to promote access to mass public transit through increased density, affordable housing, and walkability. Mercer Island is required to adopt regulations to comply with HB 1491 by December 31, 2029. If the City does not comply by the deadline, then the regulations in HB 1491 supersede the City's existing development code.

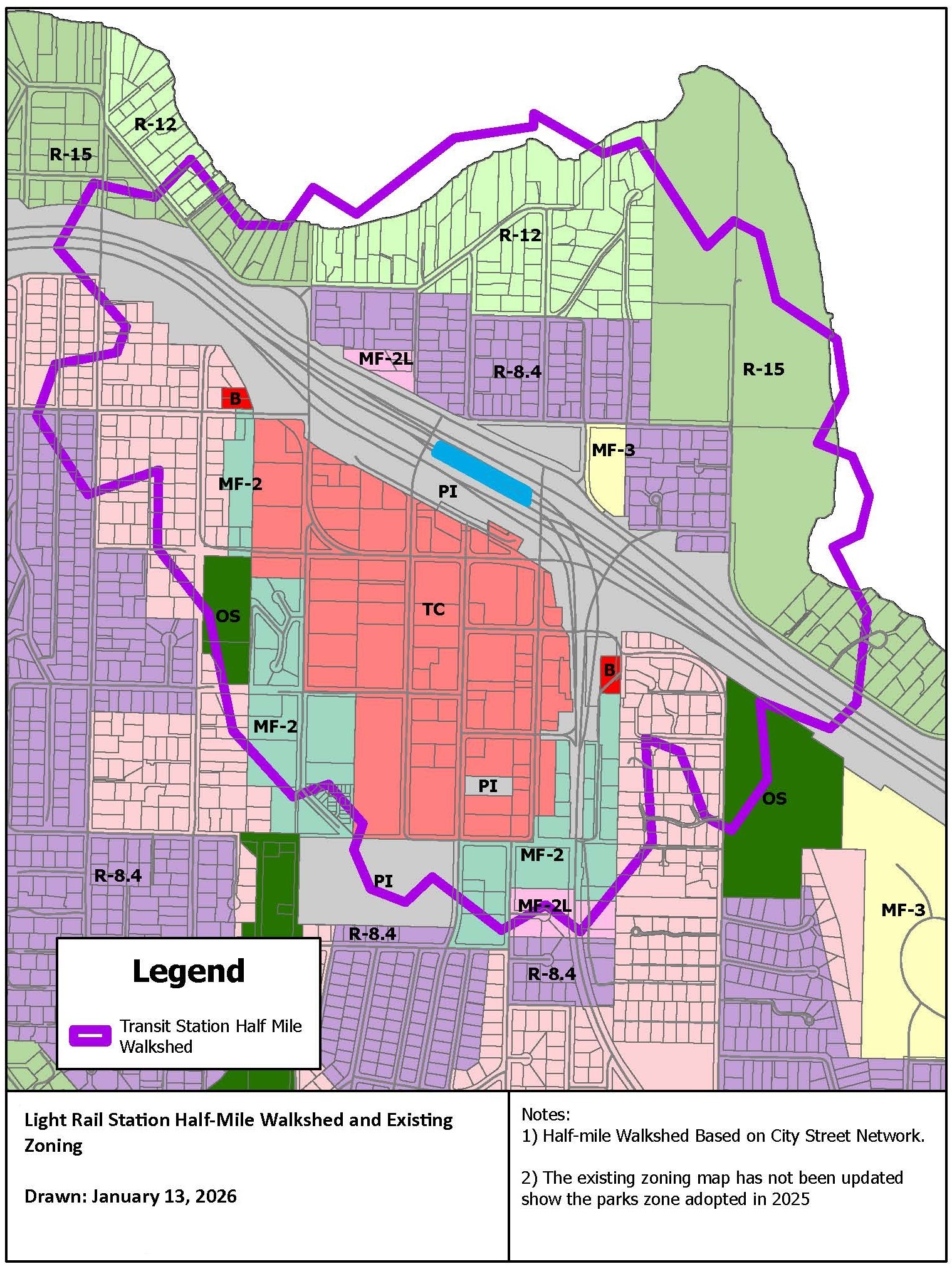

    A map of the half-mile walkshed from the light rail station.


    Overview of HB 1491 Requirements

    Under HB 1491, cities with light rail stations must designate all lots fully or partially within one-half mile walking distance of the entrance to the light rail station as a station area (RCW 36.70A.030(32)). Within the designated station area, cities are required to:

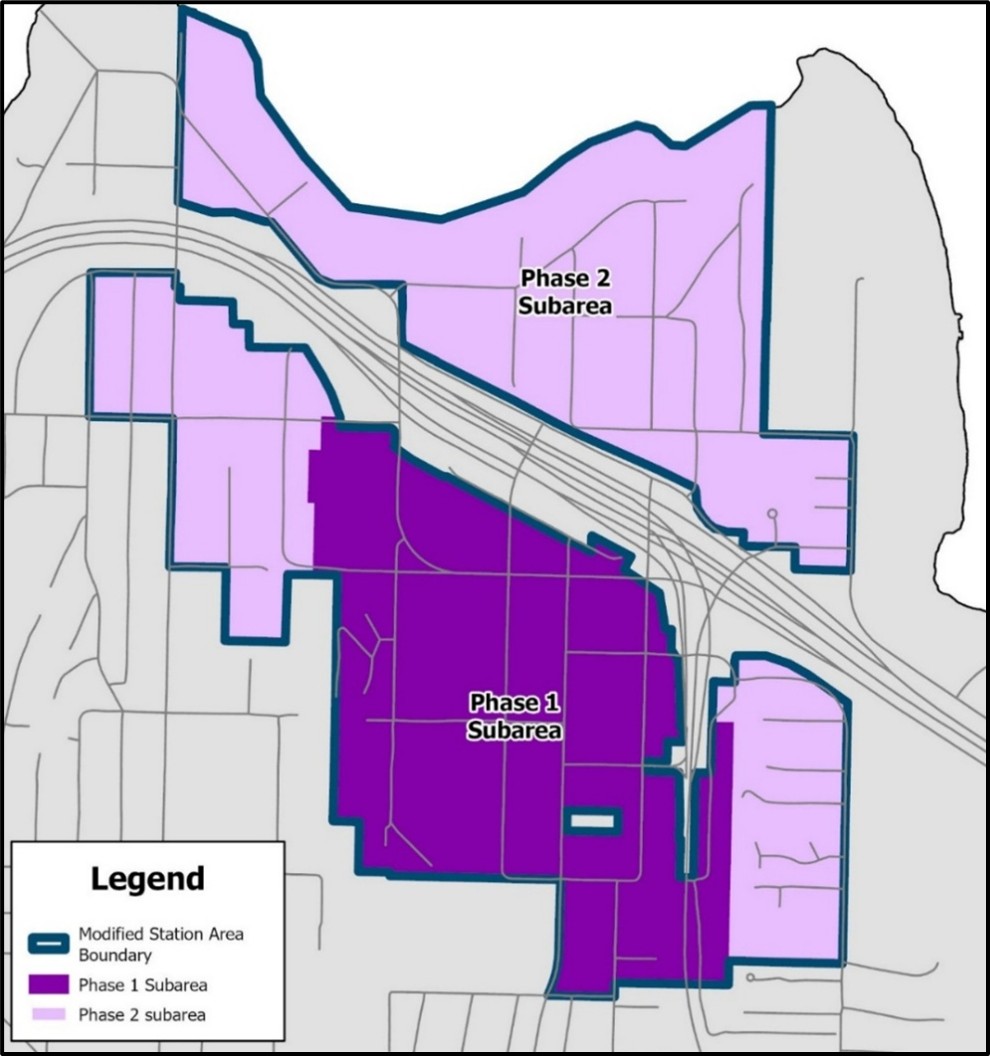

    • Allow an average of 3.5 floor area ratio (FAR), approximately between 4 to 8 stories, across the entire station area. Some areas may have a reduced FAR provided other areas have a greater FAR and the average allowed is not less than 3.5;
    • Require that a minimum of 10% of all units must be affordable (at 60% of the Average Median Income (AMI) for rental housing and 80% of the AMI for owner-occupied housing);
    • Grant an additional 1.5 FAR for developments that have 100% of units as either permanent supportive housing (units affordable at 0-30% of the AMI) or workforce housing (affordable at 80% of the AMI); and,
    • Allow multifamily residential and mixed-use development.
    • Reduce on-site parking requirements in residential or mixed used development.

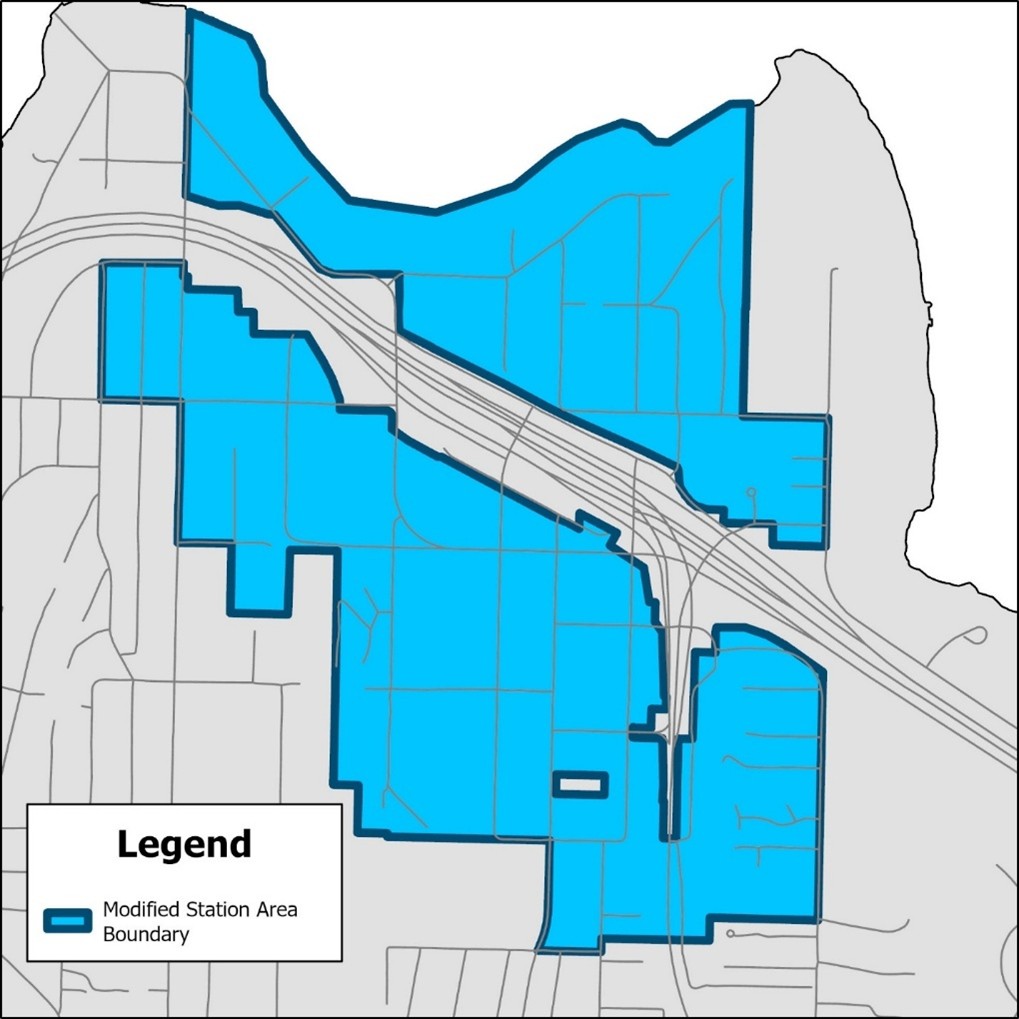

    The City is allowed to designate a modified station area, subject to review and approval by the Washington State Department of Commerce (RCW 36.70A.840). Some areas may be exempted from the station area, such as the shoreline jurisdiction, critical areas, and parks. The City Council will be providing further direction on the boundary of a modified station area in the coming weeks.

  • Understanding the Growth Management Hearings Board Order and Appeal Outcome

    Share Understanding the Growth Management Hearings Board Order and Appeal Outcome on Facebook Share Understanding the Growth Management Hearings Board Order and Appeal Outcome on Twitter Share Understanding the Growth Management Hearings Board Order and Appeal Outcome on Linkedin Email Understanding the Growth Management Hearings Board Order and Appeal Outcome link

    Cities and counties in Washington State are required to adopt a comprehensive plan under the Growth Management Act (GMA). The comprehensive plan is a statement of goals and policies that detail how a county or city will manage and accommodate future growth. The goals and policies of the comprehensive plan are implemented through capital investments, development regulations, and programs. The GMA requires cities and counties to periodically review and update their comprehensive plans on a ten-year cycle. Mercer Island most recently completed a periodic review and update of its Comprehensive Plan in 2024. More information about this project can be found on the previous Comprehensive Plan Periodic Update Let's Talk project page, and the introduction article, Putting the Comprehensive Plan in Context.

    The 2024 adoption of the Mercer Island Comprehensive Plan periodic review and update was appealed to the Growth Management Hearings Board (GMHB) on the grounds that the Comprehensive Plan did not adequately plan for and accommodate future affordable housing needs (GMHB case number 25-3-0003). On August 1, 2025, the GMHB issued a Final Decision and Order (GMHB Order) finding that the Housing Element of the Comprehensive Plan was noncompliant with some of the provisions of the GMA and remanded the Comprehensive Plan to the City for revision.

    The Comprehensive Plan adopted in 2024 remains in effect during the remand, but the City must complete work to update the plan and comply by the timeline established by the GMHB Order (RCW 36.70A.300(3)(b)). The compliance timeline is one year from when the GMHB issued its decision; work must be completed by July 31, 2026. Failure to comply with the GMHB Order can result in sanctions against the City (RCW 36.70A.340).

    The GMHB Order requires the City to address four issues:

    1. Land Capacity Analysis: Identify residential land capacity at each housing affordability level and close any identified gaps.
    2. Adequate Provisions: Adopt incentives, mandatory provisions, and planned actions (“aka adequate provisions”) that will increase the supply of affordable housing.
    3. Station Area Subarea Plan: Adopt a subarea plan for the area around the transit station.
    4. Anti-Displacement Measures: Adopt anti-displacement measures to address the potential displacement that can occur with changes in zoning.

    Each of these items are discussed in greater detail in the following sections. Addressing these four issues is expected to constitute a substantial revision of the Comprehensive Plan, including the Land Use, Housing, Capital Facilities, Utilities, and Transportation Elements. In addition to amending the elements of the Comprehensive Plan, compliance with the GMHB Order will also require amendments to the City’s development code and may include revisions to the zoning map.


    GMHB ORDER - ISSUE #1: Land Capacity Analysis

    Cities are required to complete a land capacity analysis as part of the Periodic Update to the Comprehensive Plan. A land capacity analysis calculates how many housing units and how much commercial space can be accommodated under a comprehensive plan when considering existing development; vacant and redevelopable land; development regulations such as critical areas, shoreline development standards, and maximum densities; and, market factors. The land capacity analysis must demonstrate the City is able to meet its growth target and housing affordability levels as assigned by King County.

    Under the GMA, counties and cities are required to plan for adequate housing to accommodate the projected housing needs for each income segment (RCW 36.70A.070(2)(a)-(d)). The GMA establishes housing affordability levels based on income segments as a percentage of the Area Median Income (AMI). The housing affordability levels are categorized as follows:

    1. Extremely Low Income (less than 30% of the AMI)
    2. Very Low Income (between 30 and 50% of the AMI)
    3. Low Income (50 to 80% of the AMI)
    4. Moderate Income (80 to 120% of the AMI)
    5. High Income (greater than 120% of the AMI)

    Table 1. Mercer Island Housing Needs by Housing Affordability Level.

    Source: King County Ordinance 19660 approved 8/22/2023.

    Notes:

    1. PSH = Permanent Supportive Housing
    2. Emergency Housing is its own metric and not part of the housing need or housing growth target.

    The City’s total allocated housing growth is 1,239 units expected over the 20-year planning period of the Comprehensive Plan, which are further broken down by the housing affordability level as summarized in Table 1 above. The GMA now also requires cities to evaluate land capacity for each housing affordability level per RCW 36.70A.070(2)(a), which requires a Housing Element that:

    “(a) Includes an inventory and analysis of existing and projected housing needs that identifies the number of housing units necessary to manage projected growth, as provided by the department of commerce, including:

    (i) Units for moderate, low, very low, and extremely low-income households; and

    (ii) Emergency housing, emergency shelters, and permanent supportive housing;”

    Revisiting the Land Capacity Analysis in 2023 and 2024

    During the Comprehensive Plan periodic review completed in 2024, and as a result of the changes set forth by HB 1220 in 2021, the City prepared a Land Capacity Analysis Supplement (AB 6385) that was presented to the City Council on January 2, 2024. The City followed Commerce guidance for this analysis and considered multifamily development capacity as the appropriate capacity to accommodate housing needs for households with low income levels (earning less than 80 percent AMI). An analysis of the aggregated land capacity in the Land Capacity Analysis Supplement indicated that the City had a housing deficit of 143 units of multifamily development capacity. To address this deficit, the City increased the maximum building height in some areas of the Town Center and expanded the affordable housing requirement for development in the Town Center, which formed the final policy recommendations adopted by the City Council.

    August 2025 GMHB Order: Remands Land Capacity Analysis Back to City

    The GMHB Order found that the City’s approach to calculating the land capacity was not adequate to determine capacity for each housing affordability level, and that when relying on voluntary incentives zoning, the City needed to examine how many affordable units had been created in the past and at what income levels. The GMHB Order directed the City to reevaluate land capacity to estimate expected production of housing units in each affordable housing level and demonstrate that the City is accommodating its housing needs at each housing affordability level, particularly by accommodating affordable housing for households earning low income, very low income, and extremely low income.


    GMHB ORDER - ISSUE #2: Adequate Provisions

    “Adequate provisions” was introduced as a new planning requirement as part of the suite of policy directives that encompassed HB 1220 in 2021. “Adequate provisions” are a combination of mandatory provisions, policies, incentives, subsidies, and planned City actions that, when taken together with development capacity, allow conditions for the City to meet its housing needs at each housing affordability level over the 20-year planning horizon. For example, the City code currently provides a height bonus in the Town Center to incentivize the construction of affordable housing units. The maximum building height in Town Center is two stories, but buildings that provide affordable housing units at an established ratio may construct additional floors. This is an example of an existing policy that falls under the umbrella of “adequate provisions.”

    2024 Comprehensive Plan Adequate Provisions in the Housing Element

    The Housing Element of the 2024 Comprehensive Plan identified the following policies to be developed and implemented upon adopted of the Comprehensive Plan to meet the “adequate provisions” requirements of HB 1220:

    1. Height bonus
    2. Multifamily Tax Exemption (MFTE)
    3. Reduced design review process
    4. Reduction or waiver of permit fees
    5. Reduction or waiver of parking requirements
    6. Fee-in-lieu
    7. Establish a housing fund
    8. Inclusionary zoning
    9. Leverage ARCH membership to achieve more affordable units

    Presentations and discussions with the City Council assumed that these policies would be developed and implemented over the next five years in alignment with the state five-year implementation progress report, which requires the City to demonstrate progress towards implementation of the development regulations, zoning, land use changes or other legislative or administrative action necessary to implement the Comprehensive Plan (RCW 36.70A.130(9)).

    August 2025 GMHB Order: Remands Adequate Provisions Requirements Back to City

    The GMHB Order determined that the City was required to have implemented the “adequate provisions” policies and programs at the time of adoption of the Comprehensive Plan. The GMHB order also directed the City to perform additional analysis to ensure the “adequate provisions” will result in the City meeting its housing needs at all housing affordability levels over the 20-year planning horizon.


    GMHB ORDER - ISSUE #3: Station Area Subarea Plan

    The Mercer Island Comprehensive Plan must be consistent with VISION 2050, which is the planning document for the Puget Sound Regional Council. VISION 2050 establishes multicounty planning policies (MPPs) that coordinate growth between cities in the Puget Sound region. One MPP, MPP-DP-Action-8, requires cities to adopt subarea plans for light rail transit stations as follows:

    “Center Plans and Station Area Plans: Each city or county with a designated regional center and/or light rail transit station area will develop a subarea plan for the designated regional growth center, station area(s), and/or manufacturing/industrial center. Cities and counties will plan for other forms of high-capacity transit stations, such as bus rapid transit and commuter rail, and countywide and local centers, through local comprehensive plans, subarea plans, neighborhood plans, or other planning tools. Jurisdictions may consider grouping station areas that are located in close proximity.”

    August 2025 GMHB Order: Remands Subarea Plan to City for Completion

    The GMHB Order found that the deadline for adopting a subarea plan for the area around the new light rail station was at the time of adoption of the Comprehensive Plan.


    GMHB Order - ISSUE #4: Anti-Displacement Measures

    HB 1220 requires jurisdictions to identify displacement risk and include policies and actions in the housing element of the Comprehensive Plan to mitigate displacement associated with growth and redevelopment, particularly for low-income and vulnerable populations. Specifically, the Comprehensive Plan Housing Element must establish anti-displacement measures per RCW 36.70A.070(2)(h), which states:

    “[The Comprehensive Plan must include a housing element that] Establishes anti-displacement policies, with consideration given to the preservation of historical and cultural communities as well as investments in low, very low, extremely low, and moderate-income housing; [ … ]”

    2024 Comprehensive Plan Anti-Displacement Measures

    The Adopted 2024 Comprehensive Plan identified the following policies to be developed and implemented to meet the new anti-displacement policy requirements:

    1. Seeking partnerships to inventory naturally occurring affordable housing (NOAH)
    2. Requiring advance notice of rent increases
    3. Landlord provided relocation assistance
    4. Right of first refusal or tenant opportunity to purchase requirements when an apartment building is converted to a condominium
    5. Requiring a displacement risk analysis for any proposed zoning changes affecting a zone where multifamily or mixed-use development is allowed

    August 2025 GMHB Order: Remands Anti-Displacement Policies Back to City

    Similar to the requirements for “adequate provisions,” the GMHB Order found that the anti-displacement policies were required to be adopted at the time of adoption of the Comprehensive Plan.


    August 2025 GMHB Order - Compliance Deadline

    The GMHB requires the City to adopt the amendments to the comprehensive plan and take other necessary steps to comply with the GMHB Order by the following deadlines:

    1. January 28, 2026 – First progress report due
    2. February 27, 2026 – Second progress report due
    3. July 31, 2026 – Compliance due
    4. August 14, 2026 – Compliance report and record due
    5. September 15, 2026 – Compliance hearing

Page published: 16 Jan 2026, 03:43 PM
