First Hill Park Playground Replacement
First Hill Park is a neighborhood park located at SE 32nd Street and 72nd Avenue SE. The park playground included a treehouse play structure and hillside slide installed in 2007. In 2025, the City will remove aging play equipment and replace it with a new climbing structure, swings, and free-standing play features. Old play area surfacing will be removed and replaced with new engineered wood fiber (EWF) surfacing, and new gravel will be installed to provide an accessible pathway from the main park entrance to the renovated play area and existing picnic table.
The renovated playground design was developed with the community in 2024, and construction is anticipated to take 3-4 months. Follow along here on Let's Talk for regular construction updates and photos.
Looking for general information about Mercer Island playground replacements? Find it here: www.mercerisland.gov/playgroundreplacements.
First Hill Park is a neighborhood park located at SE 32nd Street and 72nd Avenue SE. The park playground included a treehouse play structure and hillside slide installed in 2007. In 2025, the City will remove aging play equipment and replace it with a new climbing structure, swings, and free-standing play features. Old play area surfacing will be removed and replaced with new engineered wood fiber (EWF) surfacing, and new gravel will be installed to provide an accessible pathway from the main park entrance to the renovated play area and existing picnic table.
The renovated playground design was developed with the community in 2024, and construction is anticipated to take 3-4 months. Follow along here on Let's Talk for regular construction updates and photos.
Looking for general information about Mercer Island playground replacements? Find it here: www.mercerisland.gov/playgroundreplacements.
-

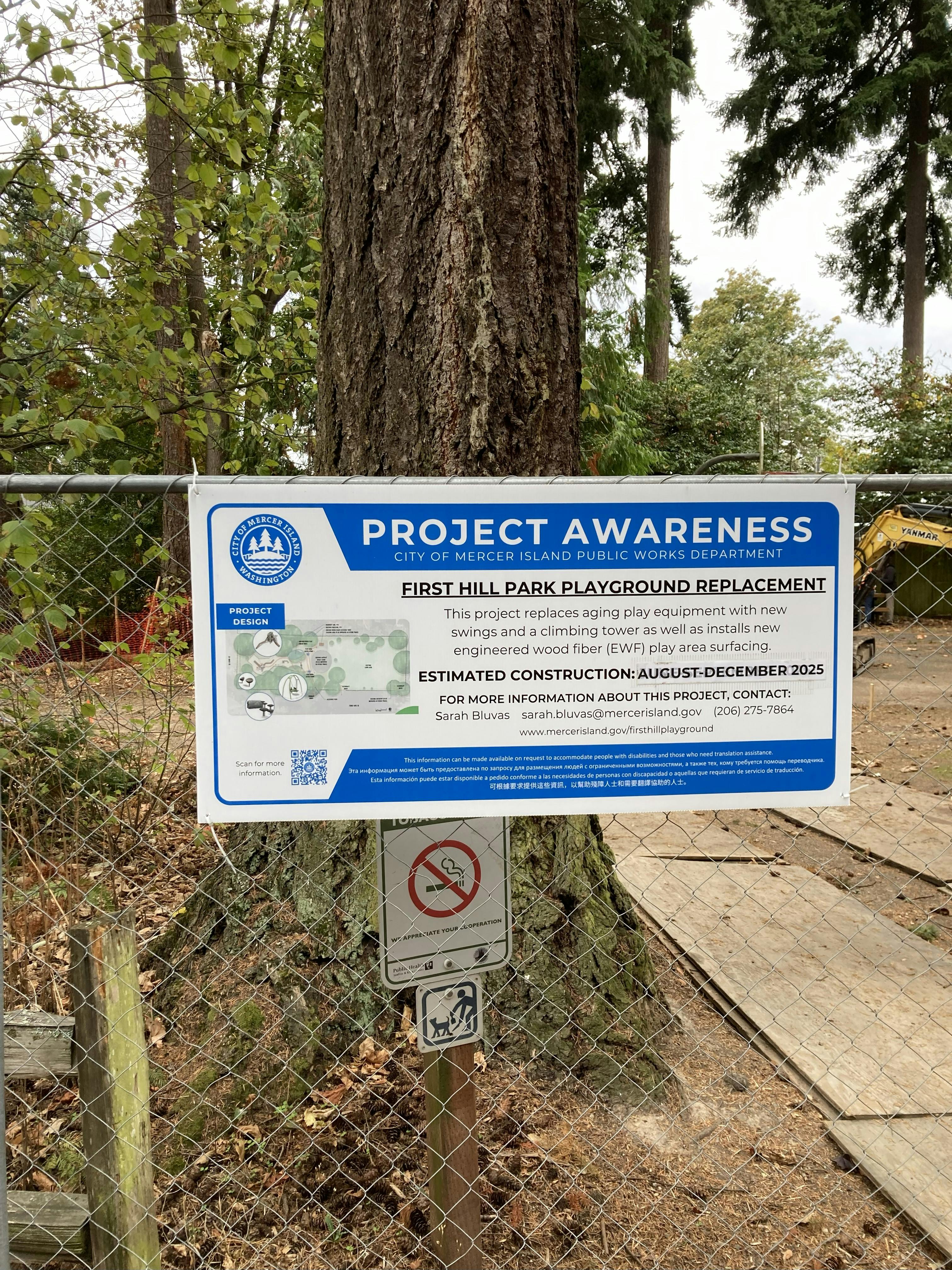

Construction Update for December 3
Share Construction Update for December 3 on Facebook Share Construction Update for December 3 on Twitter Share Construction Update for December 3 on Linkedin Email Construction Update for December 3 linkPlayground construction at First Hill Park is almost complete! Over the past month, R&R Construction:
- Finished installing all new play equipment, which includes the 20' tall Alpha Tower climbing and sliding structure, swings, mushroom steppers, log tunnel, and acorn seats
- Poured the concrete curb on the north edge of the play area and finished building the cedar timber border that encloses the rest of the playground
- Installed new gravel ramps outside of the play area and prepped for installation of new poured-in-place (PIP) ramps inside the play area, which together will enhance access for playground users of all abilities
- Completed preparations for laying the new engineered wood fiber (EWF) play area surfacing, including backfilling and adding landscape fabric
Upcoming final work includes installing the PIP ramps, adding 12" of new EWF surfacing, and powerwashing the play equipment. This project is on track to finish in the next few weeks (weather permitting). View construction progress photos here.
-
Construction Update for November 5
Share Construction Update for November 5 on Facebook Share Construction Update for November 5 on Twitter Share Construction Update for November 5 on Linkedin Email Construction Update for November 5 link

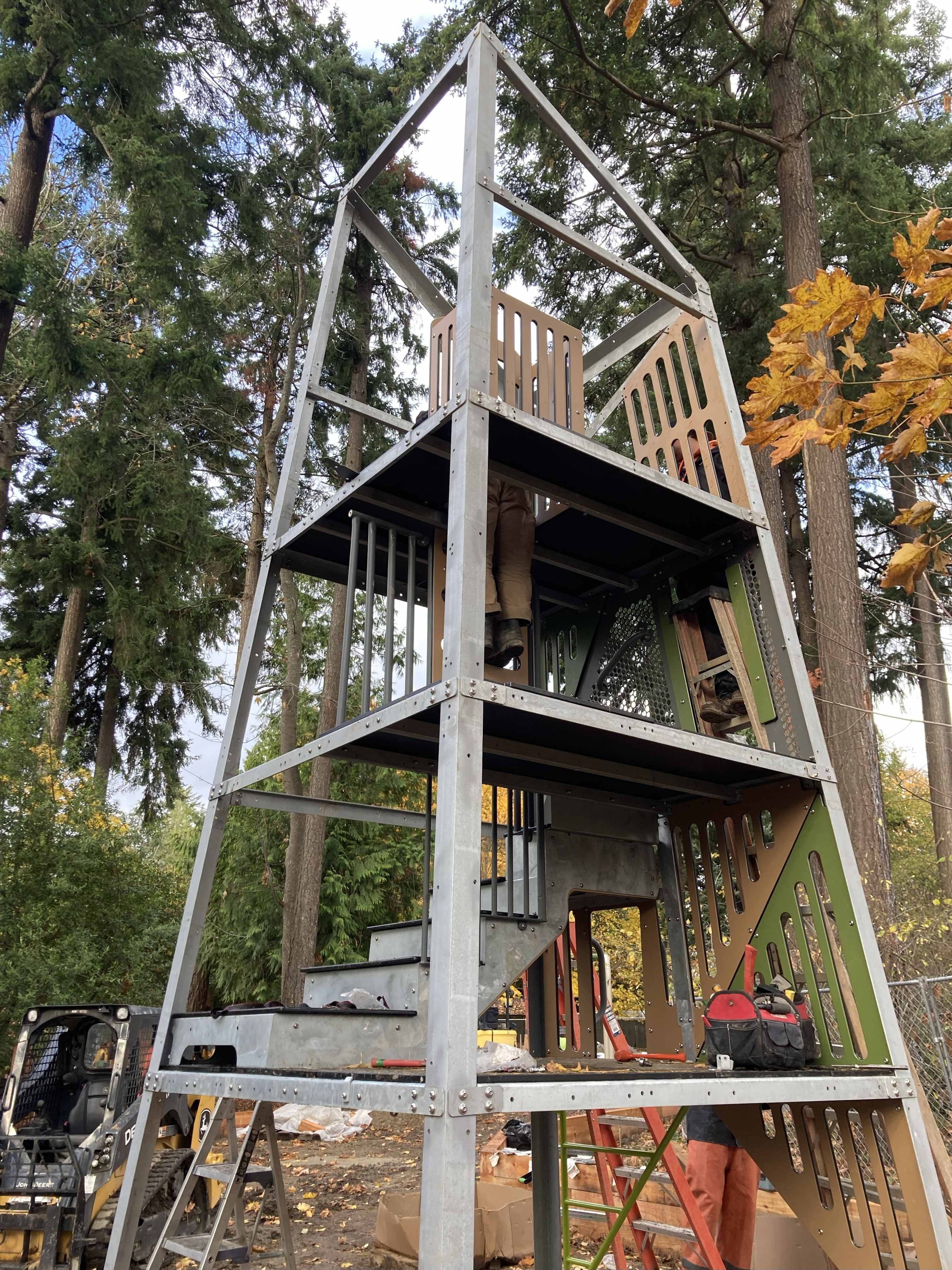

Construction has reached new heights (literally!) at First Hill Park! This week, R&R Construction began assembling the new Alpha Tower, a 20’ tall structure designed for ages 5-12. The tower features two slides – a double slide for riding two at a time from the 8’ deck and a winder slide to ride from the 12’ deck. Once fully installed, the tower will be the tallest playground structure in the City's playground system!
Other work completed over the last few weeks includes:
- Pouring the concrete slab for the log tunnel, which will connect to mushroom steppers to create a free-play space in the middle of the renovated play area
- Installing the posts for the new 2-belt swing set
- Building the cedar timber wall that will enclose the play area
- Backfilling the play area in preparation for installing the new engineered wood fiber (EWF) play surfacing
Upcoming work includes pouring the concrete curb at the play area entrance, finishing the timber border, and completing the play equipment install. Construction remains on track and is expected to conclude in December. View construction progress photos here.
-
Construction Update for October 15
Share Construction Update for October 15 on Facebook Share Construction Update for October 15 on Twitter Share Construction Update for October 15 on Linkedin Email Construction Update for October 15 link

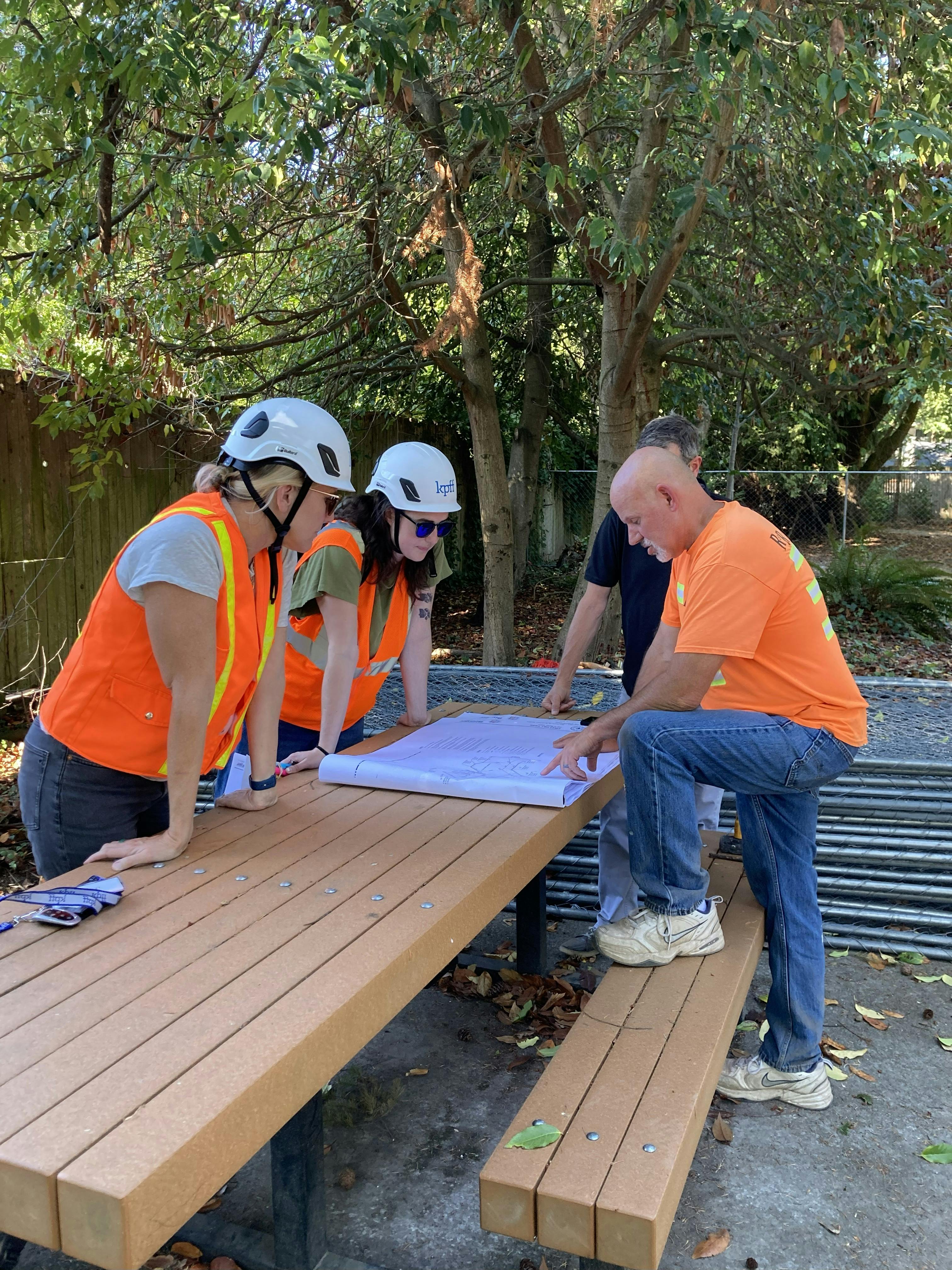

R&R Construction continues preparations for installing the new timber border and concrete curb that will enclose the renovated play area. The project team met on site last week to field-adjust a few grade elevations, and the concrete subcontractor has also started forming the new concrete curb. In the coming weeks, the concrete curb will be poured, and the new timber border will begin to take shape. The Parks team also delivered the new play equipment to the park. It will be stored at the construction site until it can be installed in November. View construction progress photos here.
-
Construction Update for October 8
Share Construction Update for October 8 on Facebook Share Construction Update for October 8 on Twitter Share Construction Update for October 8 on Linkedin Email Construction Update for October 8 link
Construction is moving along at First Hill Park! Over the past few weeks, R&R Construction has completed the following:

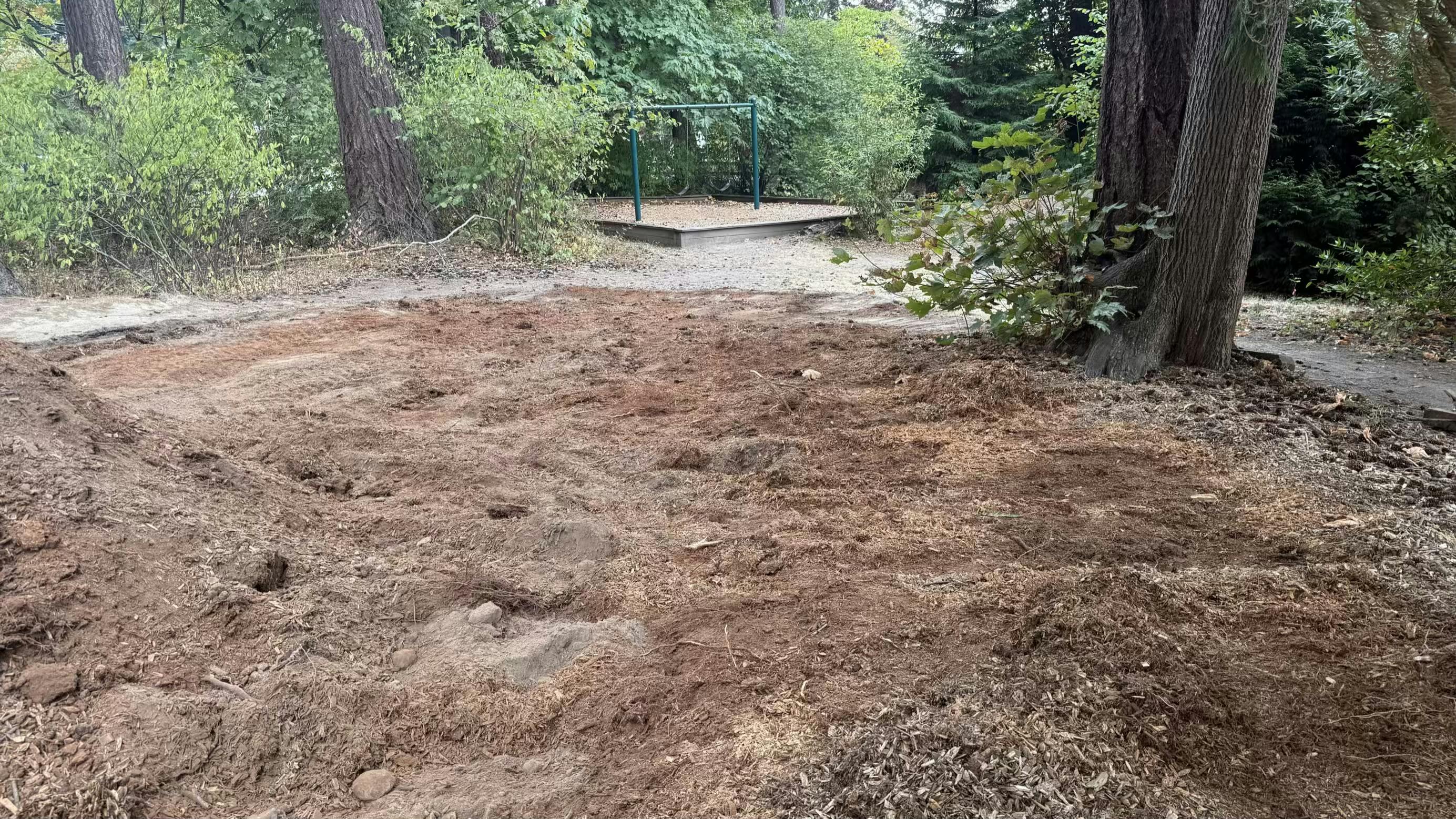

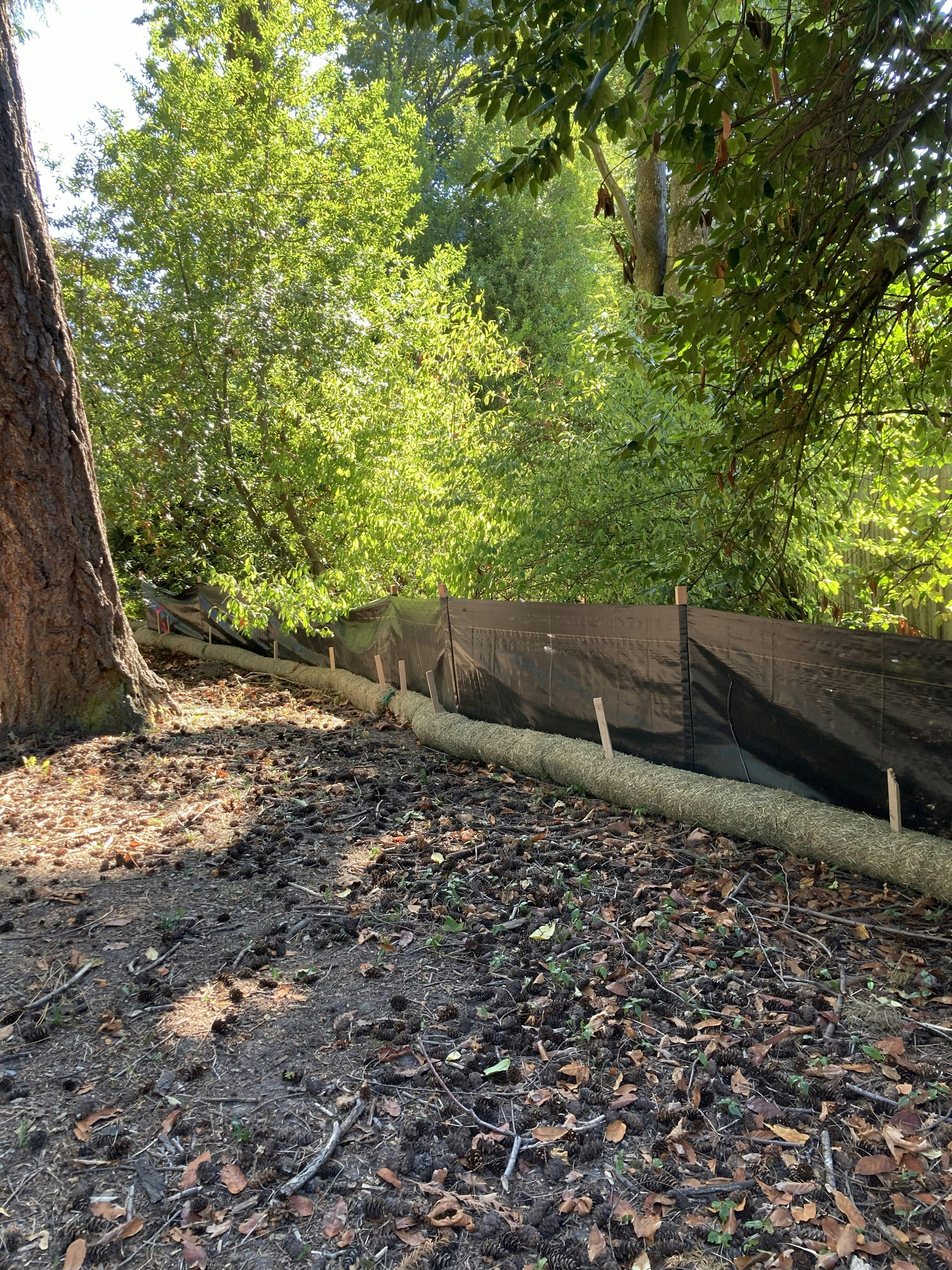

- Installed tree protection and temporary erosion control measures

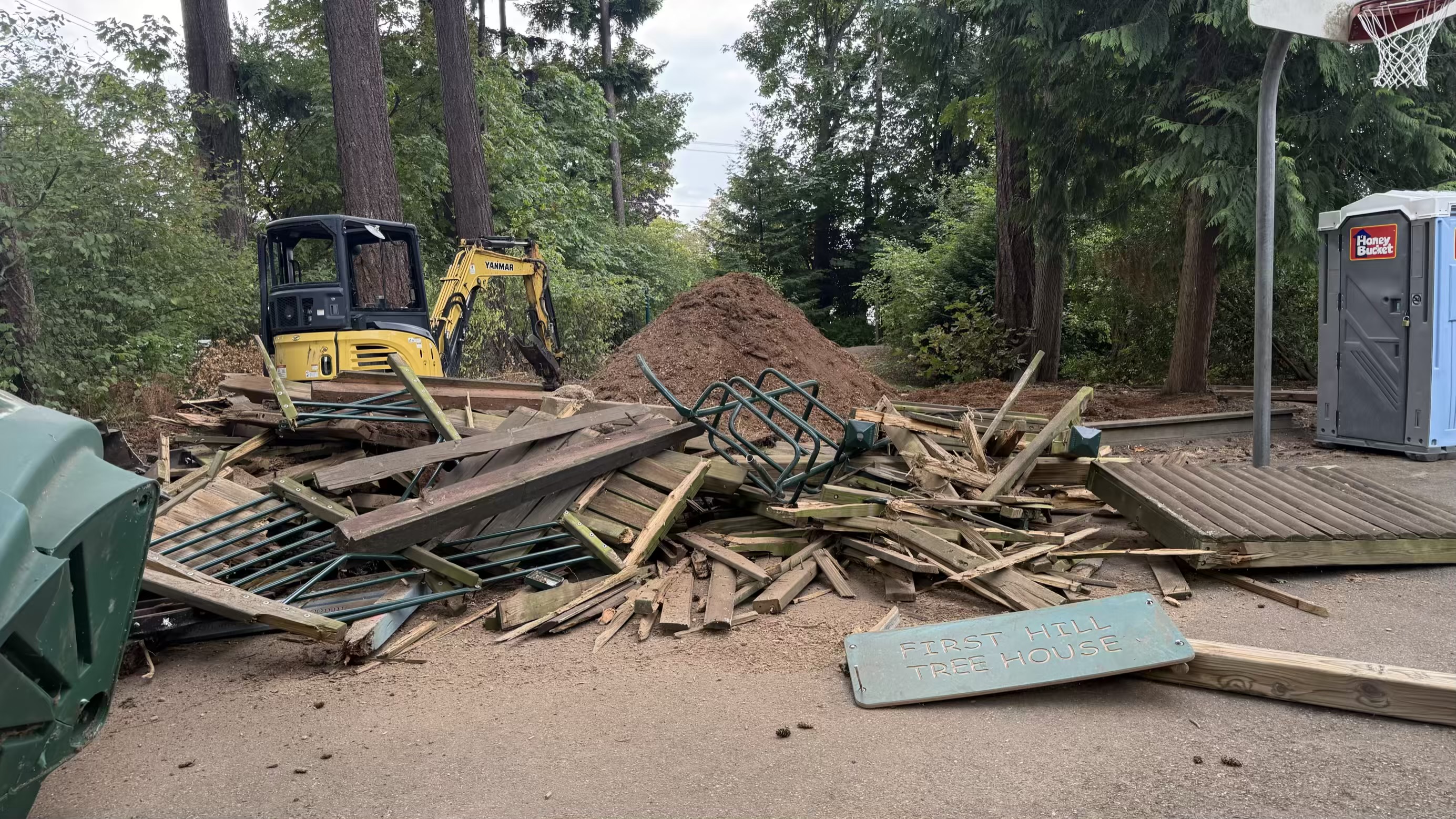

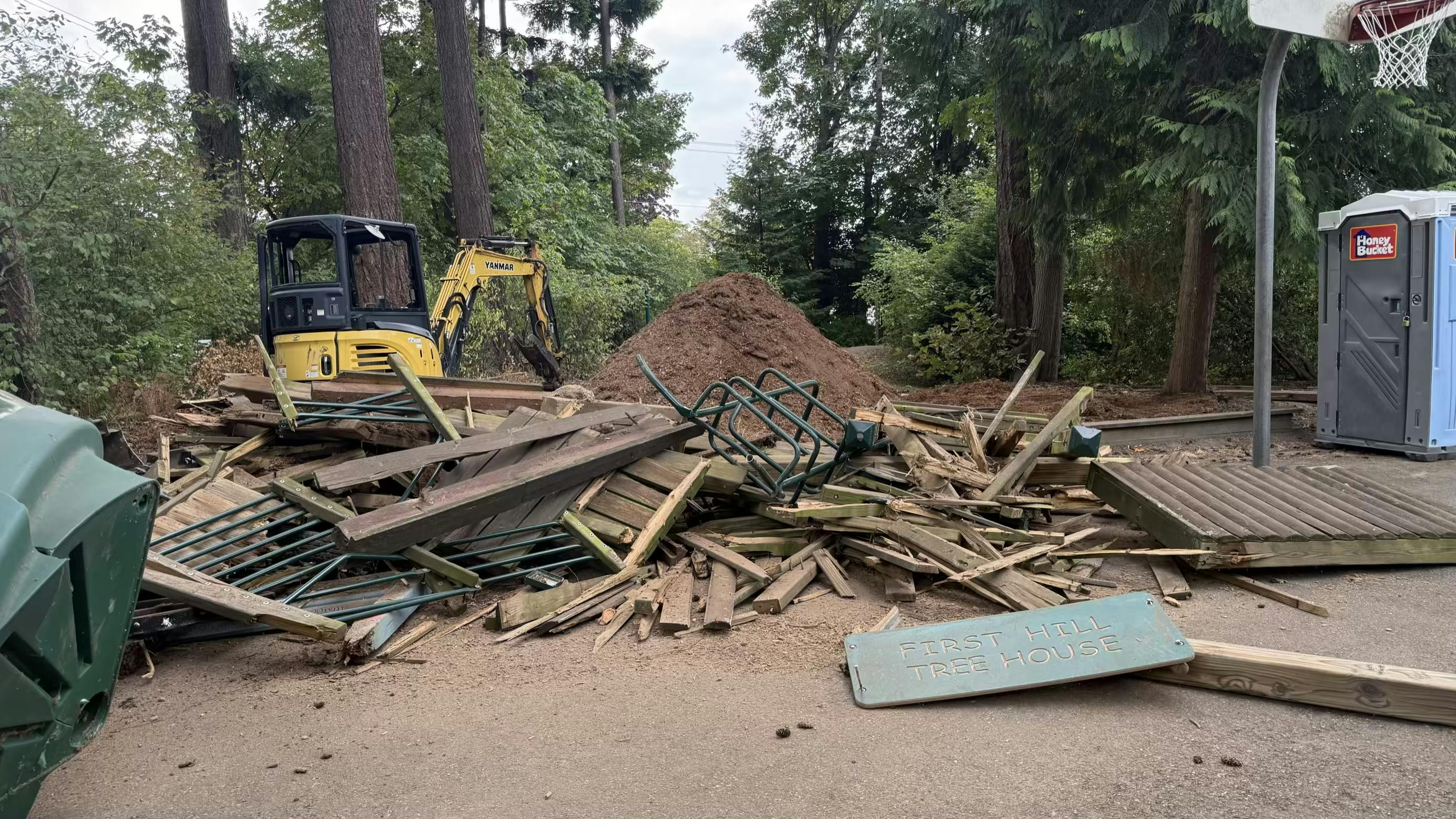

- Demoed existing playground equipment, play area surfacing, and timber curb border
- Started light grading in preparation for the new timber border and concrete curb that will define the renovated play area
Over the next several weeks, the contractor will form and pour the concrete curb and build the new timber border. City crews will also deliver the new play equipment, which has been stored at the Public Works Shop since February, to the park for installation soon.
Construction is expected to take 3 to 4 months. View progress photos here.
-
Updates for April 2025
Share Updates for April 2025 on Facebook Share Updates for April 2025 on Twitter Share Updates for April 2025 on Linkedin Email Updates for April 2025 linkProgress to replace aging equipment and renovate the play area at First Hill Park continues! Keep reading for an update on equipment delivery, permitting, and expected construction timing.

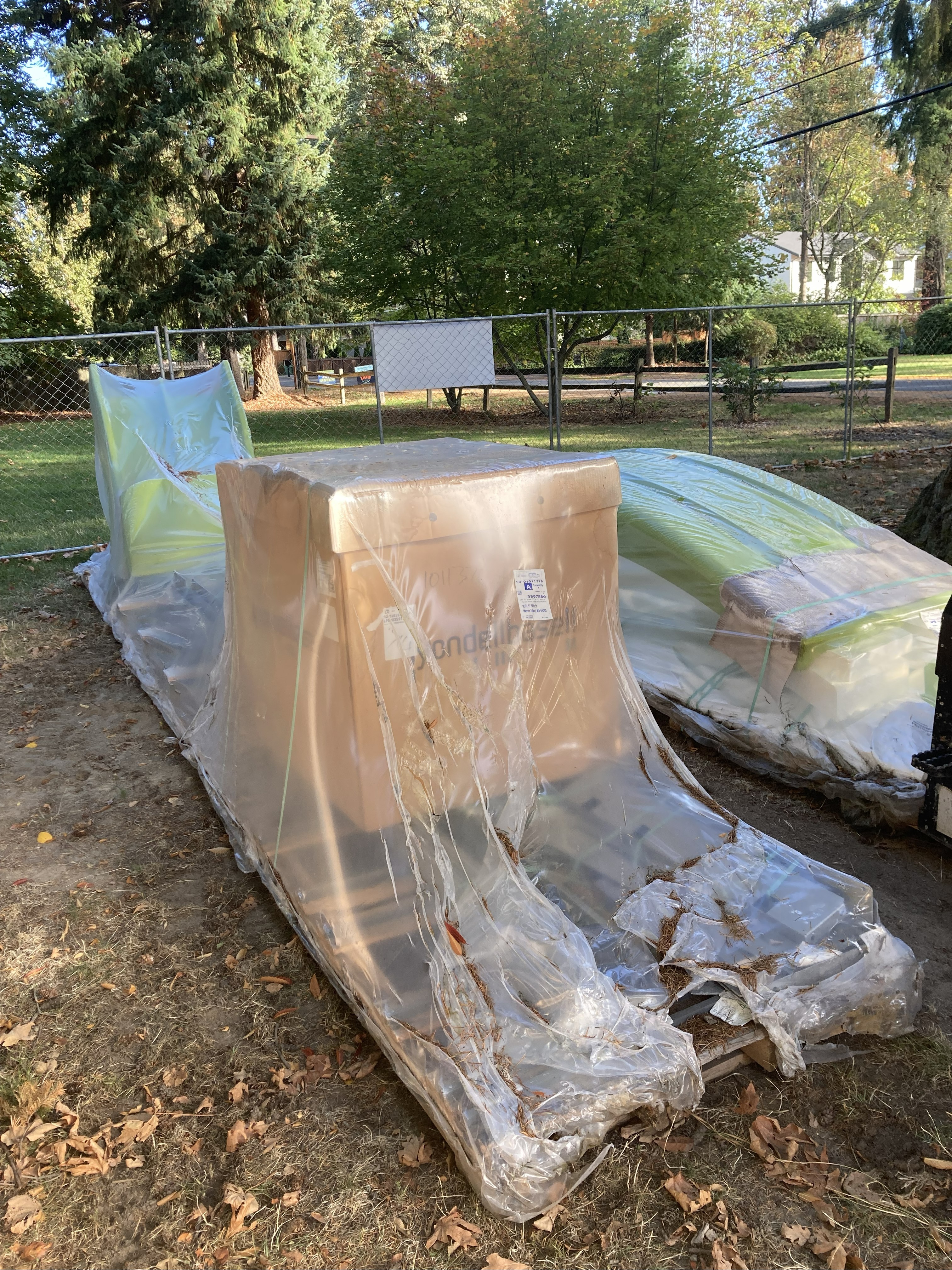

- Play equipment delivered – New play equipment from Landscape Structures, Inc., was delivered in February and is being stored at Public Works until construction begins. Pieces include a multi-level tower structure with two slides; a two-swing bay of traditional belt swings; and nature-themed steppers, seats, and a tunnel.
- Permits secured – The City building permit was approved last month, and staff are working with the Community Planning and Development department to finalize the permit issuance.
- Confirming construction scope and timing – This week, City staff, the Berger team, and representatives from PlayCreation will meet on-site to refine the construction scope and project schedule. Staff aim to execute the construction contract in the next several weeks and anticipate construction will take 2-3 months to complete.
Questions? Contact Sarah Bluvas, CIP Project Manager, at sarah.bluvas@mercerisland.gov or 206.549.1032.
-
Play Structure Reopened!
Share Play Structure Reopened! on Facebook Share Play Structure Reopened! on Twitter Share Play Structure Reopened! on Linkedin Email Play Structure Reopened! link

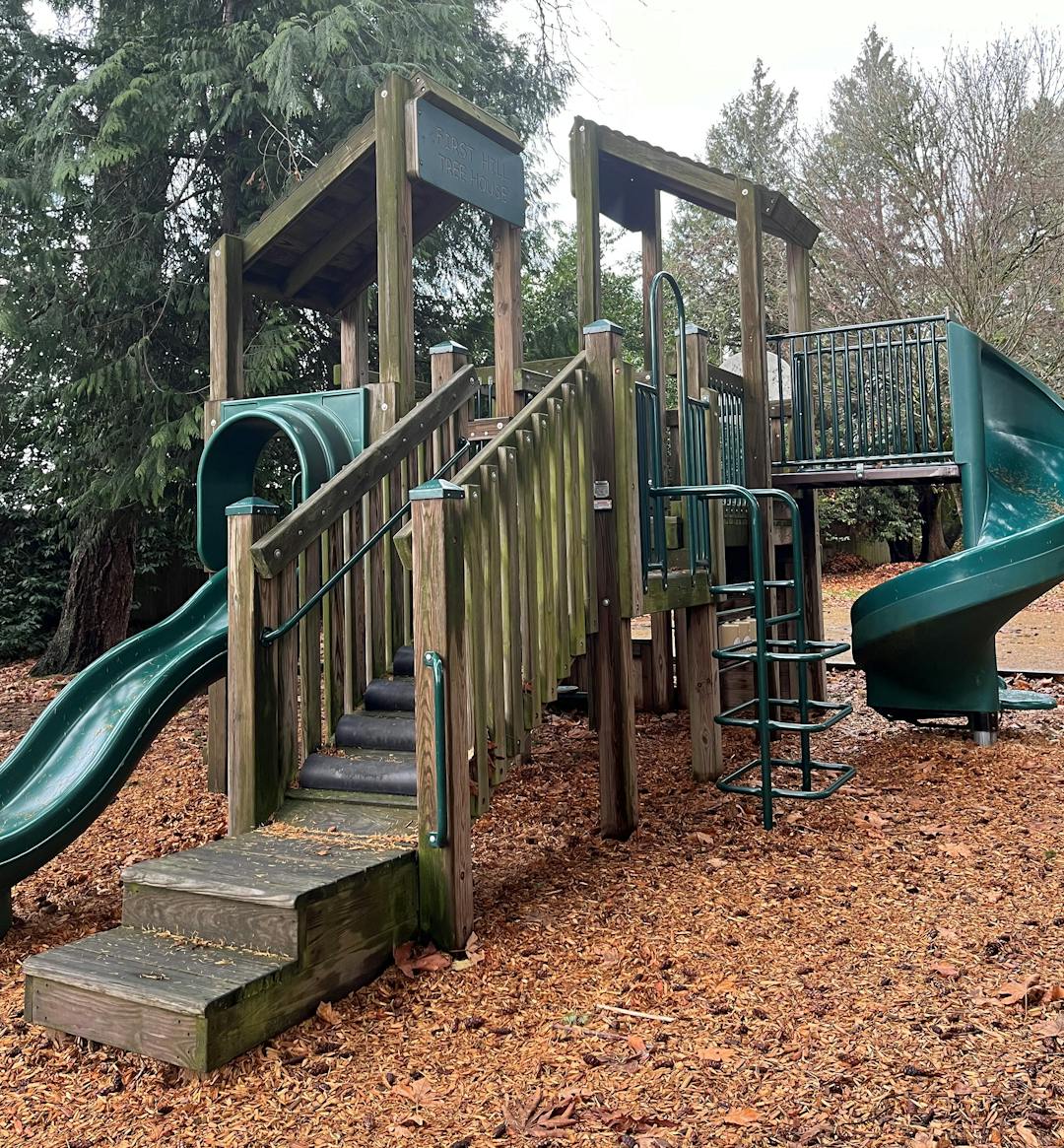

Good news! Today the City reopened the First Hill Park treehouse, which was closed in November due to wind storm damage. The Parks Maintenance team removed the broken stairwell and walled off the top of the platform, so the structure is now safe for playing once again.
The playground will remain open until construction starts later this year. Read yesterday's project update to learn more about progress and timing.
-
Updates for January 2025
Share Updates for January 2025 on Facebook Share Updates for January 2025 on Twitter Share Updates for January 2025 on Linkedin Email Updates for January 2025 link
Work to replace aging play equipment at First Hill Park continues! Here's a look at progress made since the City's last update.
- Ordered play equipment – Equipment is provided by Landscape Structures, Inc., and includes a multi-level tower structure with two slides; a two-swing bay of traditional belt swings; and nature-themed steppers, seats, and a tunnel. New structures are currently scheduled to be delivered to the City in mid-February and will be stored at the Public Works Shop until construction begins.
- Submitted permits – Staff submitted permits earlier this month and anticipate the review process will take 6-8 weeks.
- Coordinating construction details with the contractor – Like the Roanoke Park Playground project, construction at First Hill Park will be completed through the KCDA purchasing cooperative. Staff and the design team from Berger Partnership plan to meet with R&R Construction at the park next week to discuss construction scope and timing.
Construction is still planned for spring 2025 and will be coordinated with Roanoke construction as much as possible. Another update will be posted when permits have been issued and the construction schedule has been confirmed. In the meantime, contact Sarah Bluvas, CIP Project Manager, at sarah.bluvas@mercerisland.gov with project questions.
-
Play Structure Closed Due to Wind Damage
Share Play Structure Closed Due to Wind Damage on Facebook Share Play Structure Closed Due to Wind Damage on Twitter Share Play Structure Closed Due to Wind Damage on Linkedin Email Play Structure Closed Due to Wind Damage link
The treehouse at First Hill Park was damaged during last month's "bomb cyclone" wind event. While the City evaluates options for the damaged play structure, it will remain closed to the public.
An update will be posted on Let's Talk when next steps for the play structure are identified.
Thank you for helping keep the playground safe by staying out of the closed play area!
-
Updates for October 2024
Share Updates for October 2024 on Facebook Share Updates for October 2024 on Twitter Share Updates for October 2024 on Linkedin Email Updates for October 2024 linkStaff and Berger anticipate submitting for a pre-app meeting with the City’s Community Planning and Development Department (CPD) to confirm permit requirements later this month. Preparing for this milestone has included the following:
-

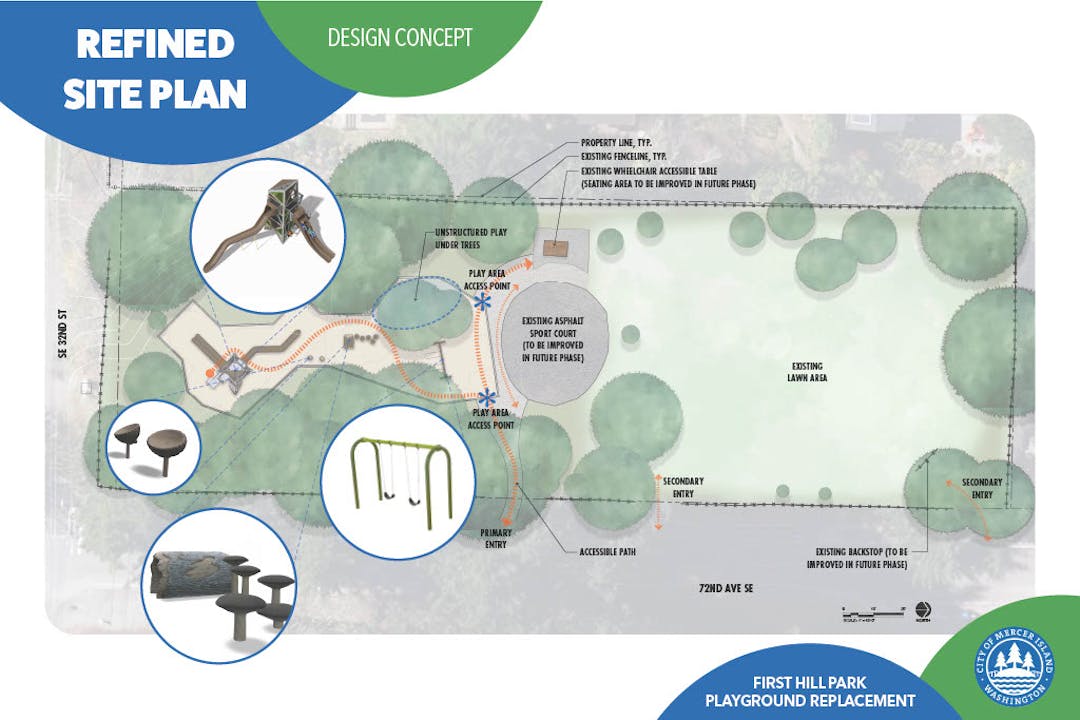

Updating the site plan design – The finalized design minimizes impacts to trees while providing an exciting climbing and sliding environment with a new multi-level tower play structure. Berger replaced the proposed saucer swing with traditional belt swings based on community feedback received this summer. Ideas to replace the hillside climbing experience continue to be explored and may be implemented during a future phase of site improvements. View the site plan that will be submitted for permitting here.
- Conducting a tree assessment – First Hill features many trees, including within the play area itself, and mitigating risks to trees will be a key component of construction. Urban Forestry Services assessed the site in August and is finalizing an arborist report, which includes recommendations for tree protection.
- Finalizing equipment order details – Equipment will be provided by Landscape Structures, Inc., and includes a multi-level tower structure with two slides; a two-swing bay of traditional belt swings; and nature-themed steppers, seats, and a tunnel. Play manufacturers are still dealing with long lead times, so equipment will be ordered before the end of the year.
Next steps include submitting for the pre-app with CPD, ordering play equipment, and executing the construction contract. Construction will be coordinated with the Roanoke Park playground replacement. Staff anticipate opening both new playgrounds in spring 2025. The playground at First Hill Park will remain open until construction begins.
-
-
Updates for August 2024
Share Updates for August 2024 on Facebook Share Updates for August 2024 on Twitter Share Updates for August 2024 on Linkedin Email Updates for August 2024 link
Thank you to all the community members who commented on the proposed site plan for the First Hill Park playground this summer! The City received 46 unique comments, which Berger is using to adjust the site plan and prepare for permitting. Staff anticipate beginning the permitting process in September and will post the refined site plan when available.
Additionally, Berger continues to explore options for providing a safe hillside climbing experience to replace the slide that will be removed as part of this project. If a suitable hillside feature is identified, it could be installed during a later phase of renovations.
Project Timeline
-
Project Initiation
First Hill Park Playground Replacement has finished this stage- Site assessment
- Playground equipment + vendor research
- ADA upgrades evaluation
-
Community Survey #1
First Hill Park Playground Replacement has finished this stageOpen March 20-April 14, 2024
Share input on your slide and other equipment preferences as well as review two multi-level tower structures being considered for the playground.
-
Community Input Opportunity #2
First Hill Park Playground Replacement has finished this stageOpen June 20-July 8, 2024
The play equipment selection and site plan concept for First Hill Park Playground are now available for community review and comment! Review the site plan and read more about how community feedback shaped the design in this post.
After reviewing the site plan concept, share share comments on the proposed design and equipment here.
-
Finalize Design, Order Equipment, Secure Permits, and Engage Contractor
First Hill Park Playground Replacement has finished this stageQ3 2024-Q3 2025
-
Playground Under Construction
First Hill Park Playground Replacement is currently at this stageQ3-Q4 2025
-
Project Complete
this is an upcoming stage for First Hill Park Playground Replacement
Construction Progress
Who's Listening
-
Phone 206-275-7864 Email sarah.bluvas@mercerisland.gov
